Case Study • Food Manufacturing

Golden West Food Group Co-Packing Plant Relocation

18M facility delivered in just 10 weeks

From groundbreaking to Temporary Certificate of Occupancy (TCO) with absolutely zero customer supply-chain disruption. Complete de-rigging, cross-country logistics, and validation managed entirely by DPS.

Successful Execution Sequence: Feb 1 – Apr 8, 2025

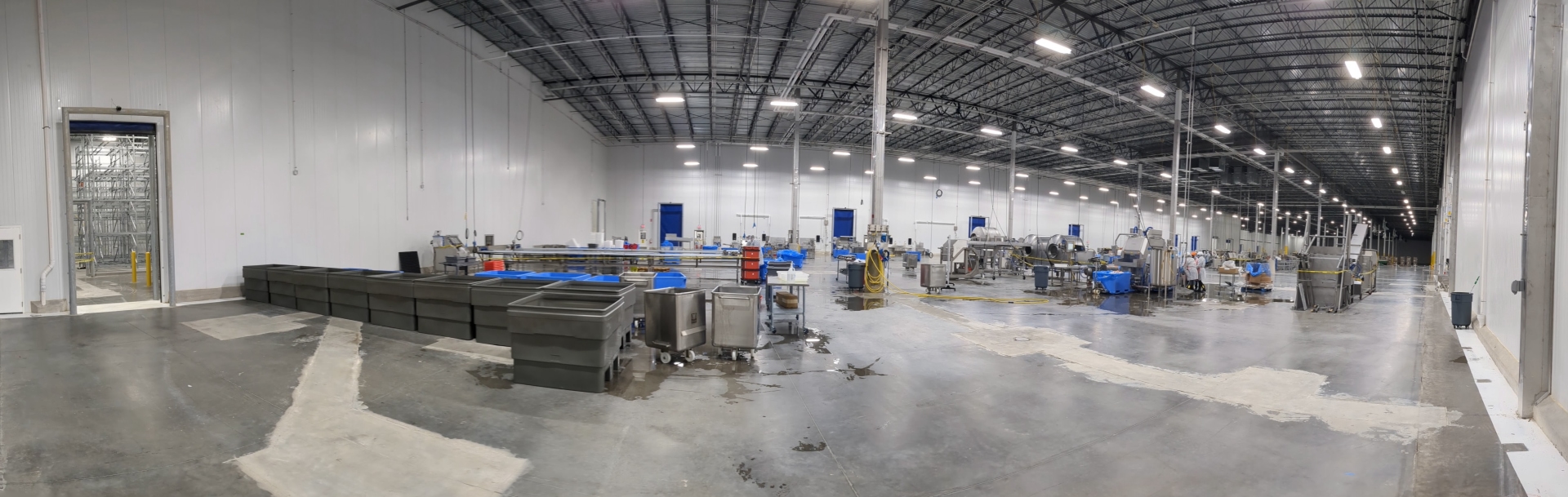

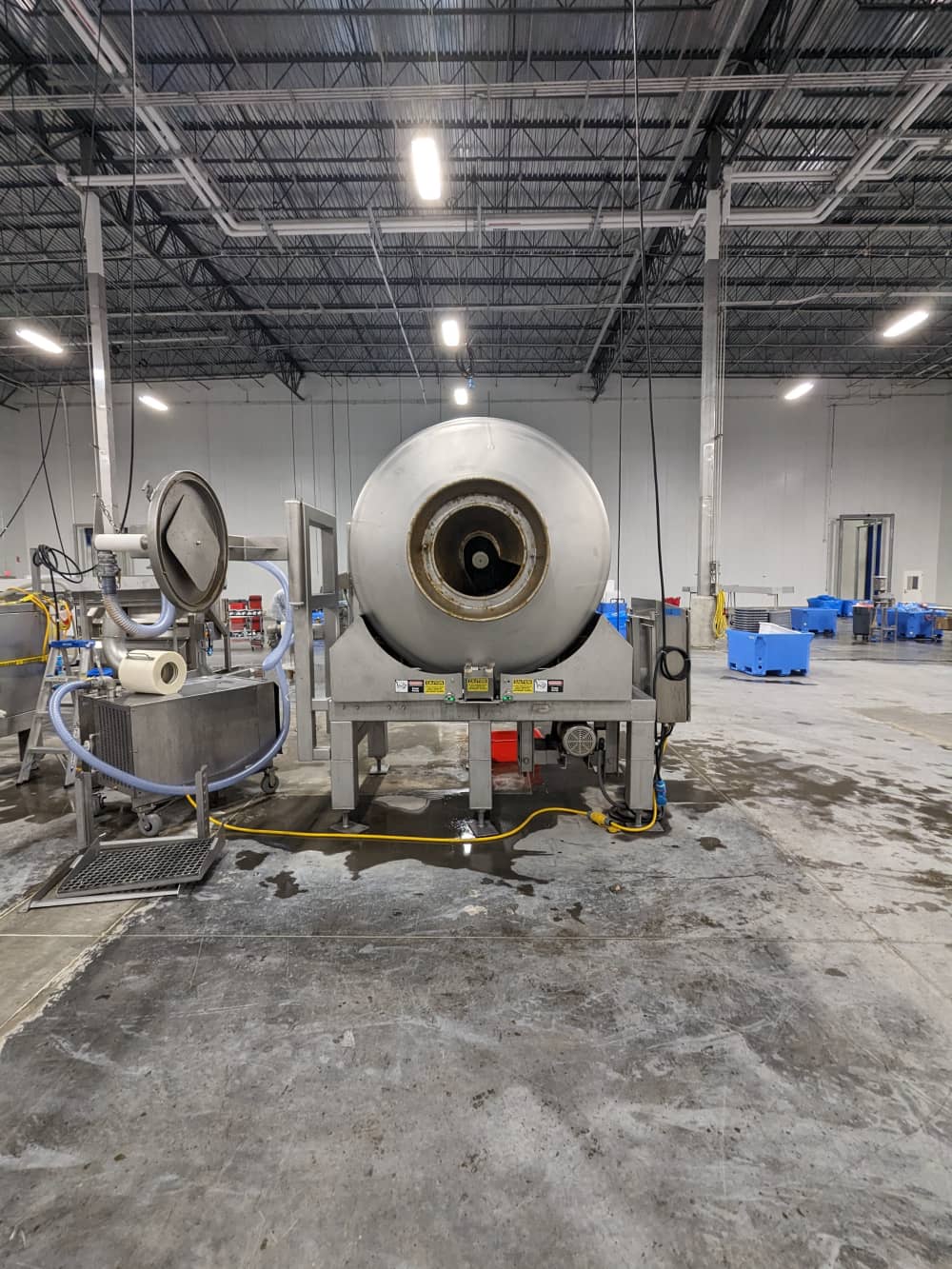

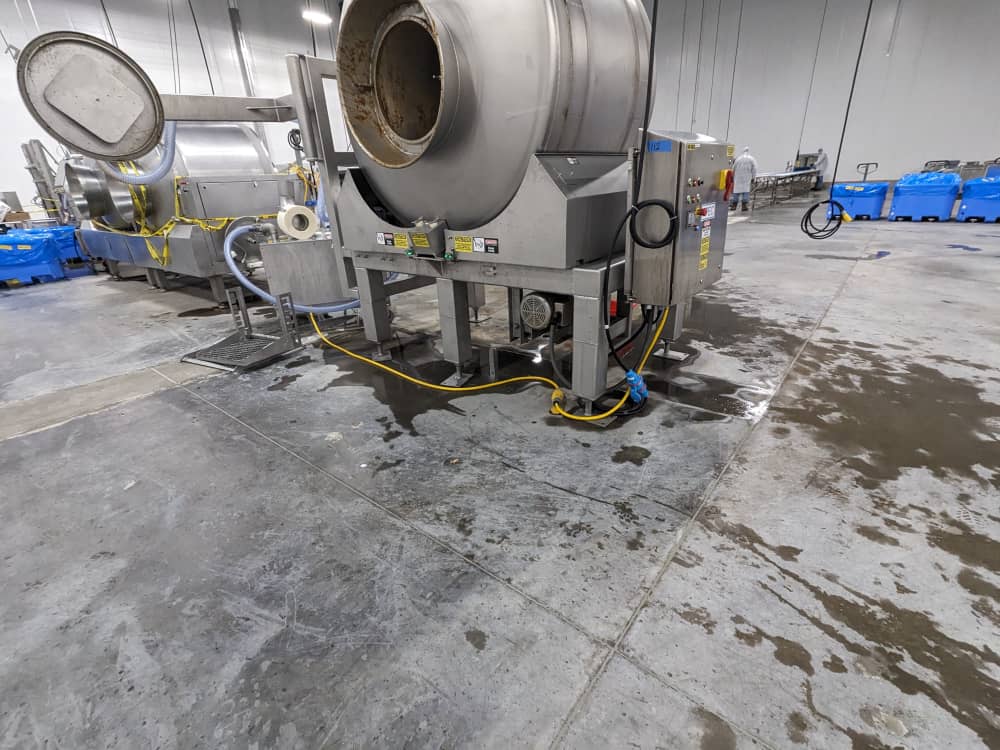

Live ProductionGolden West Food Group Processing Room Integration and Packaging Line
Duration10 Weeks

USDA • SQF • BRC First-Pass

100% compliant sanitary zoning design

National Logistics

Co-packing distribution coverage across 50 States + Canada

Zero Supply Gap

Production preserved with continuous customer distribution

Total Fast-Track

End-to-end design-build scope validation

Project Metric Successes

Delivered on Time. Delivered on Promise.

18 M

USD Total Investment

Total facility capital evaluation including mechanical integration.

10 Wks

Permit to TCO

Aggressive, double-shifted execution path from groundbreaking to closeout.

100 %

USDA First-Pass Approval

Passed all food safety compliance and regulatory parameters instantly.

0 Gaps

Supply Disruptions

Zero commercial distribution or store-level delivery incidents reported.

Case Context

The Challenge: Transitioning Multi-State Co-Packing Facilities without Operational Disruption

Golden West Food Group required a complete relocation of their active value-added food processing and co-packing operation from Los Angeles to a new facility in Fort Worth under high-density commercial deadlines.

Any physical gap during the cross-country dismantle, rigging, transportation, installation, and final clean-in-place sanitary validation phase would result in missed retail deliveries and damage corporate client agreements.

DPS METHODOLOGY

Design • Build • Manage – Executed Flawlessly

Stage One

DESIGN

Detailed process engineering, utility planning, and regulatory strategy developed in parallel with the client’s commercial goals. Every system was optimized for speed and future scalability.

Stage Two

BUILD

DPS acted as the single point of accountability — managing all civil, mechanical, electrical, and process contractors while simultaneously coordinating the cross-country equipment move.

Stage Three

MANAGE

Real-time project controls, daily stand-ups, and proactive risk mitigation ensured the project stayed on the critical path. Every decision prioritized both schedule and long-term operational excellence.

CHRONOLOGICAL TIMELINE

10 Weeks of Precision Execution

February 1 — April 8, 2025

  1. Week 0

    Permit & Mobilization

    Building permit secured Feb 1. Full design-build force mobilized, material staging grids established inside the Fort Worth facility.

  2. Weeks 1–4

    Site & Utilities Setup

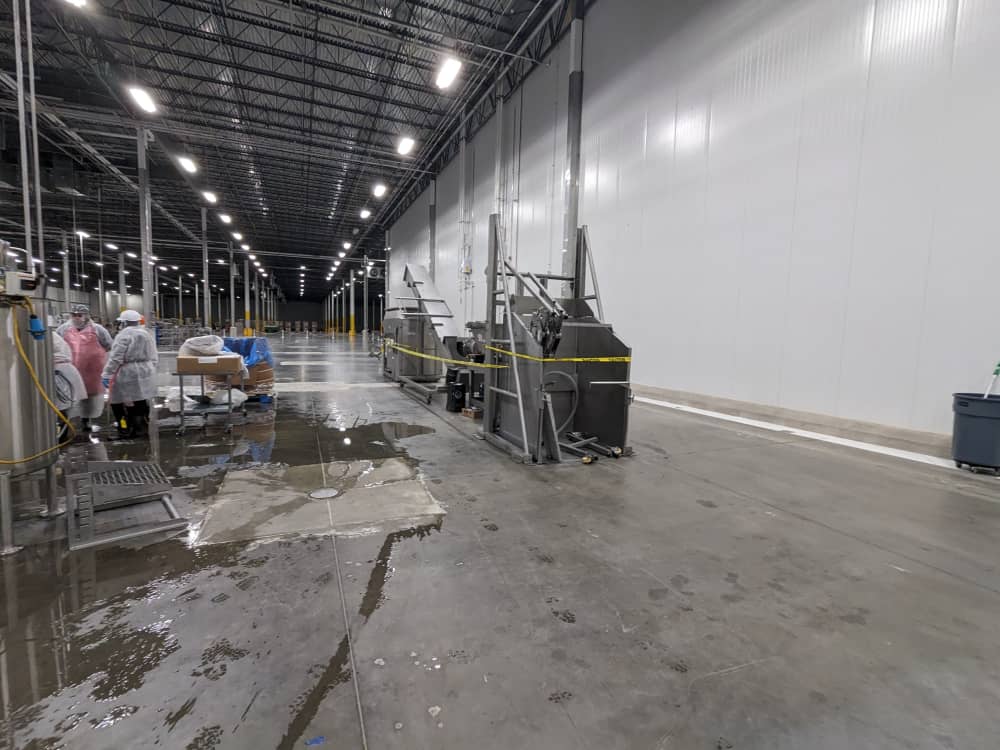

    Civil structural edits, sanitary drains, and robust process water, mechanical steam, and air lines constructed in parallel.

  3. Weeks 4–7

    Machine Relocation

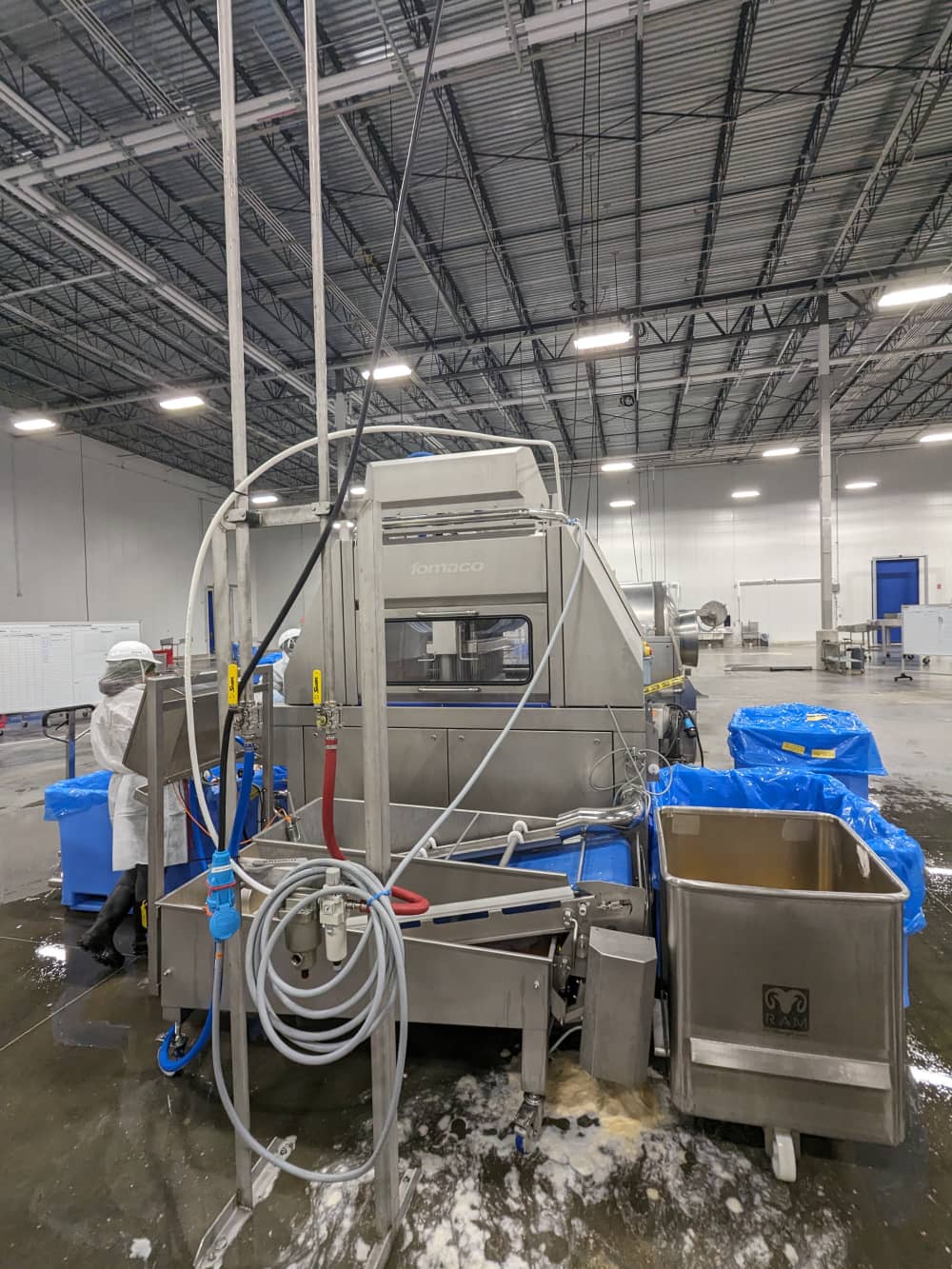

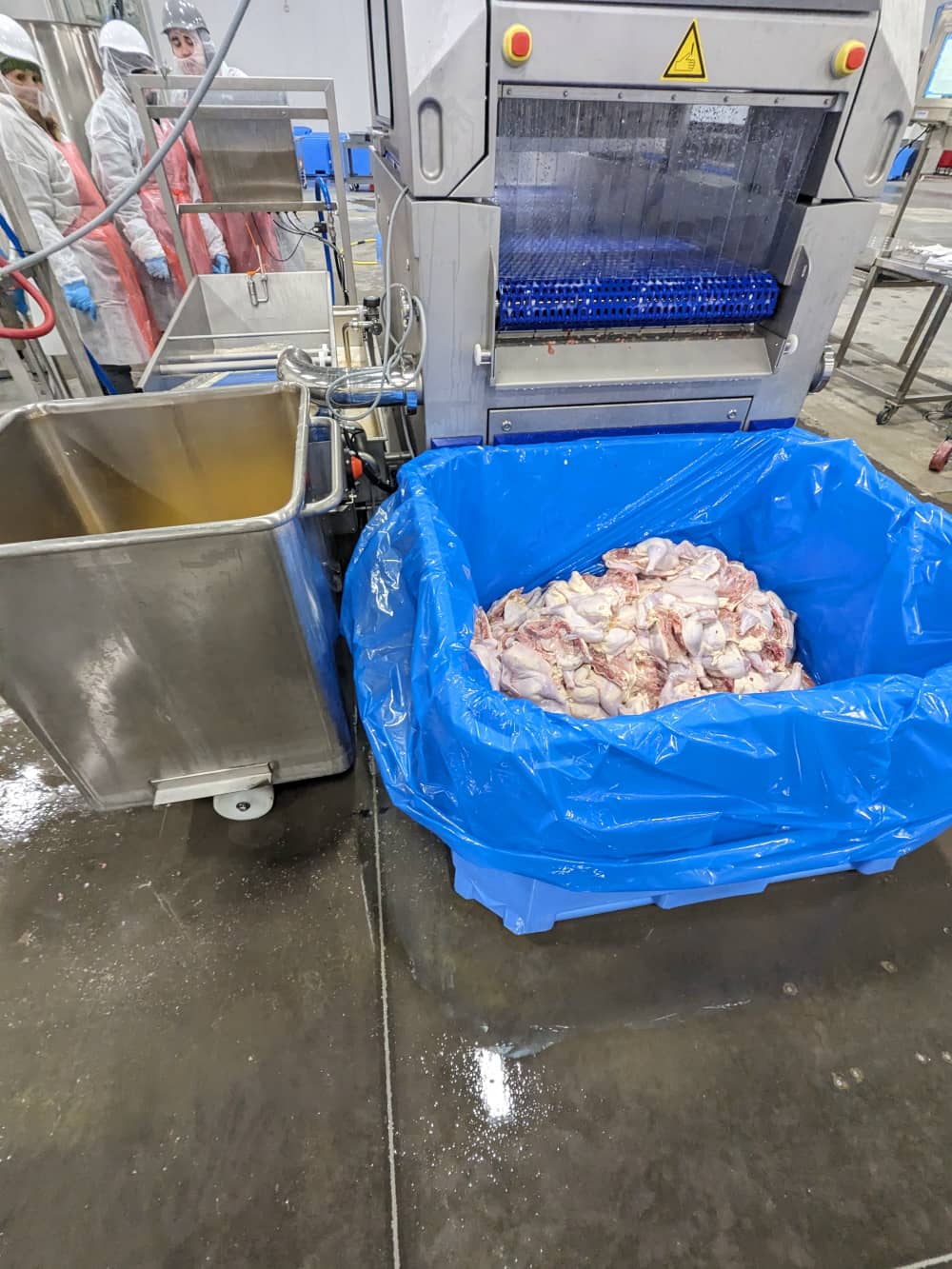

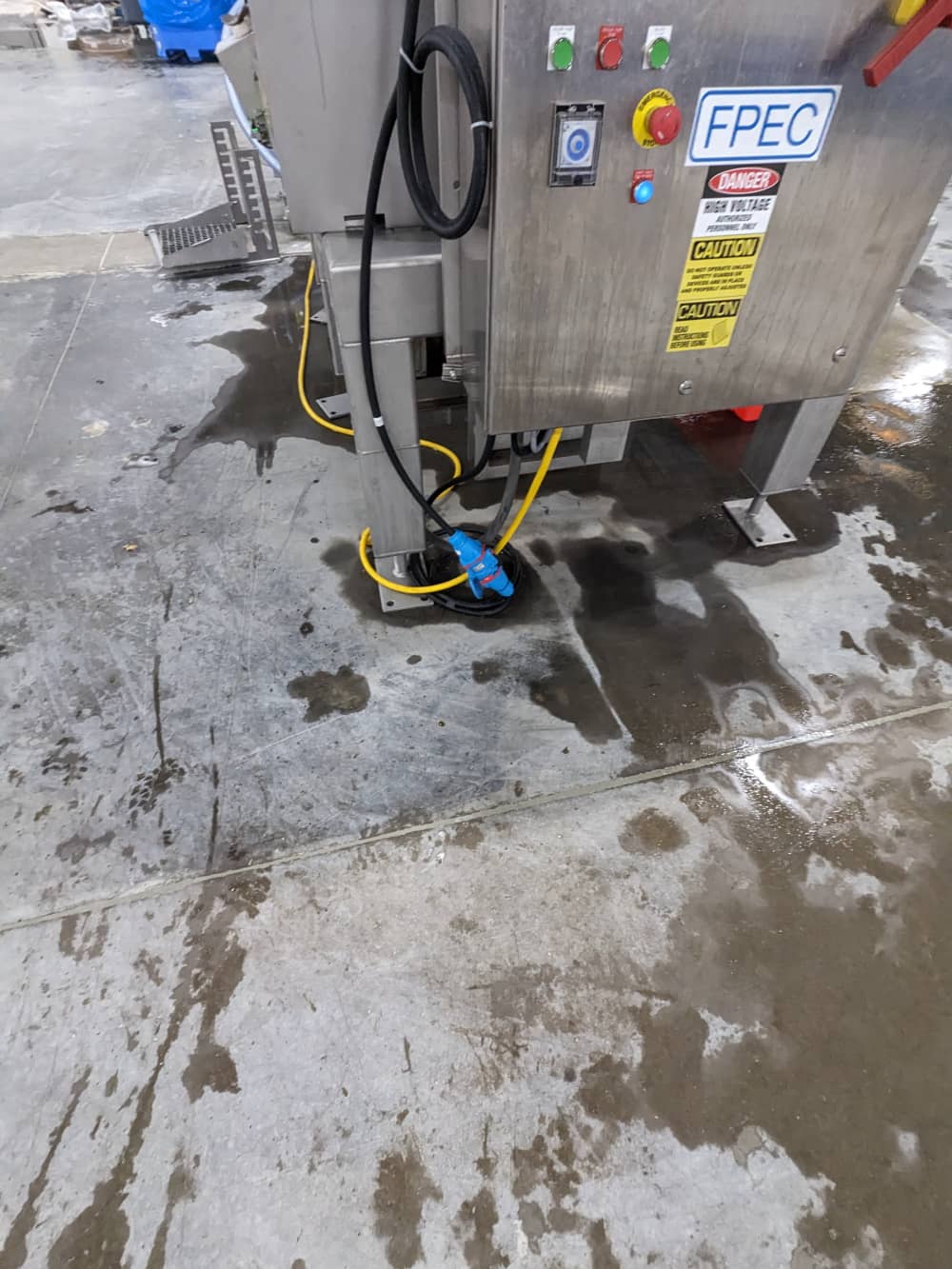

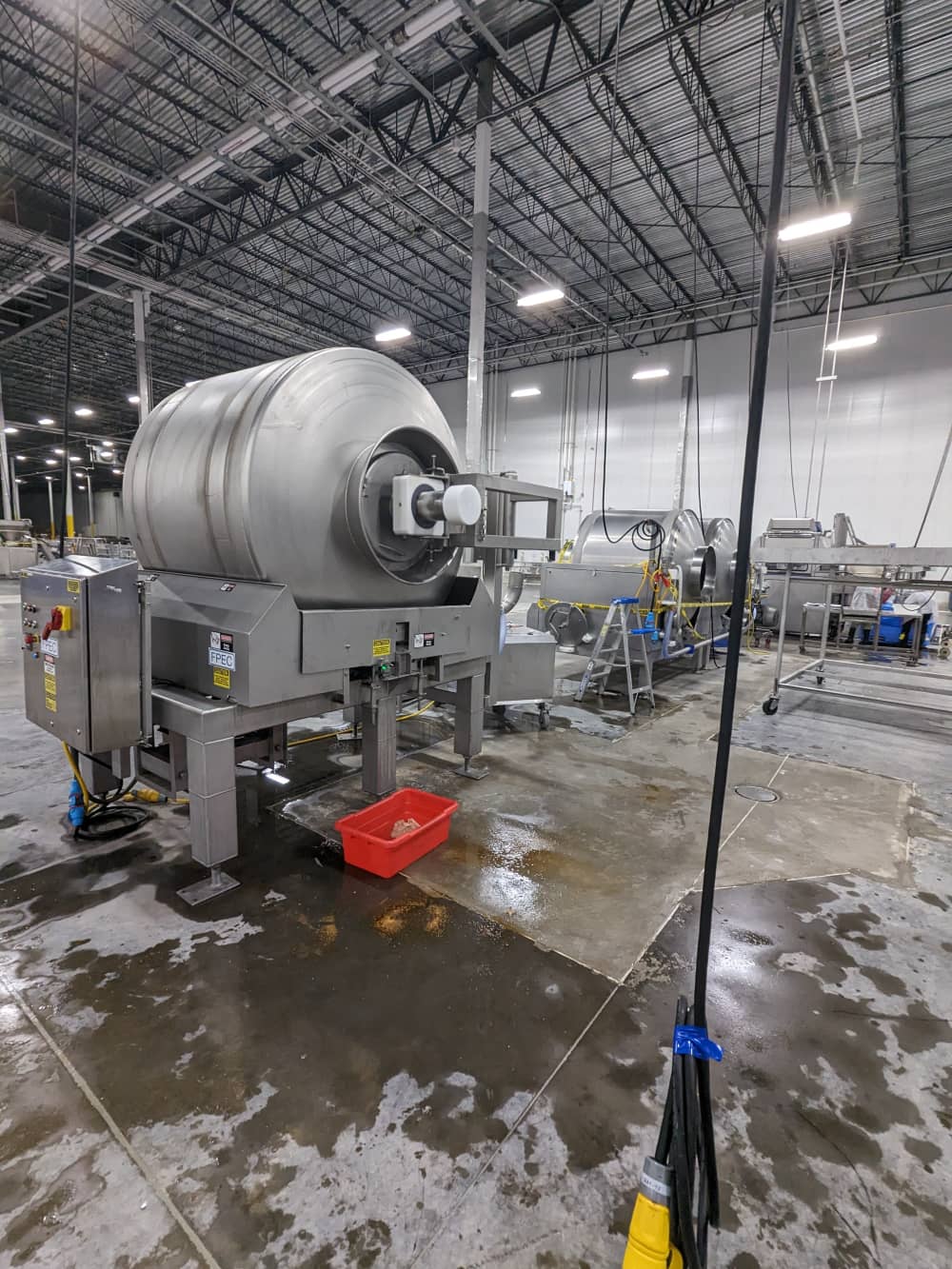

    Dismantling cooking and packing segments in LA and shipping across regions. Relocated components positioned and leveled on-site.

  4. Weeks 7–9

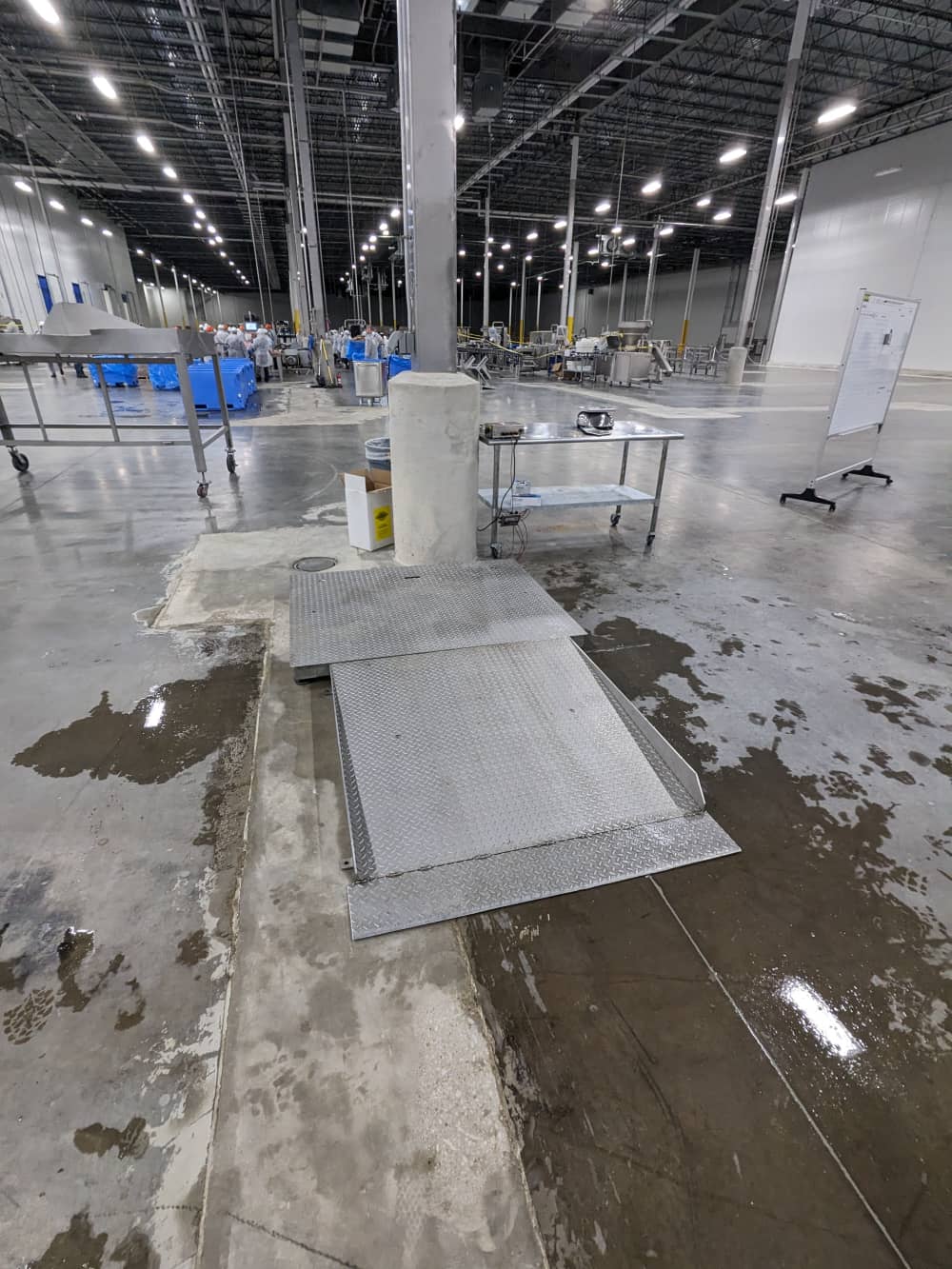

    Validation

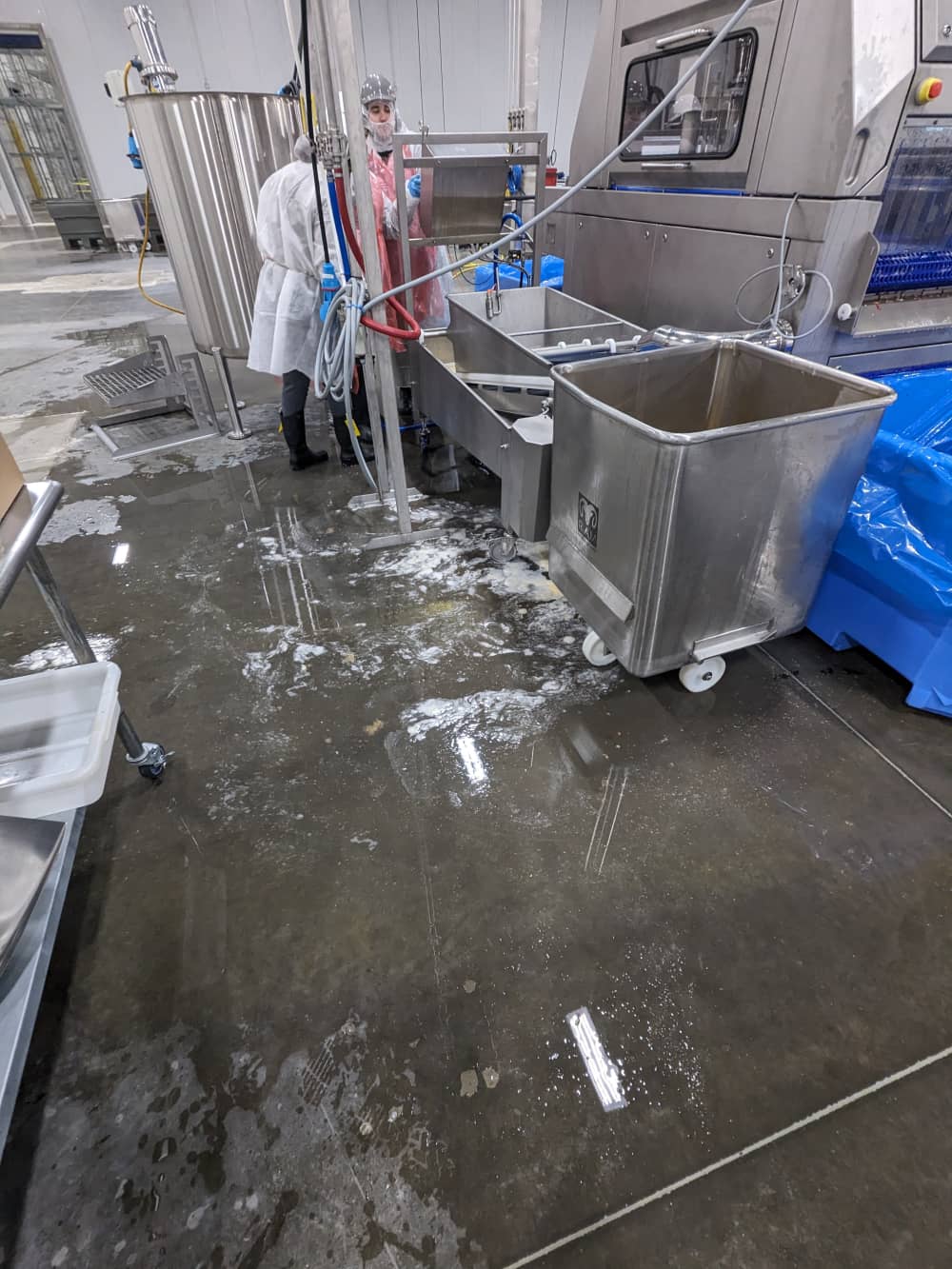

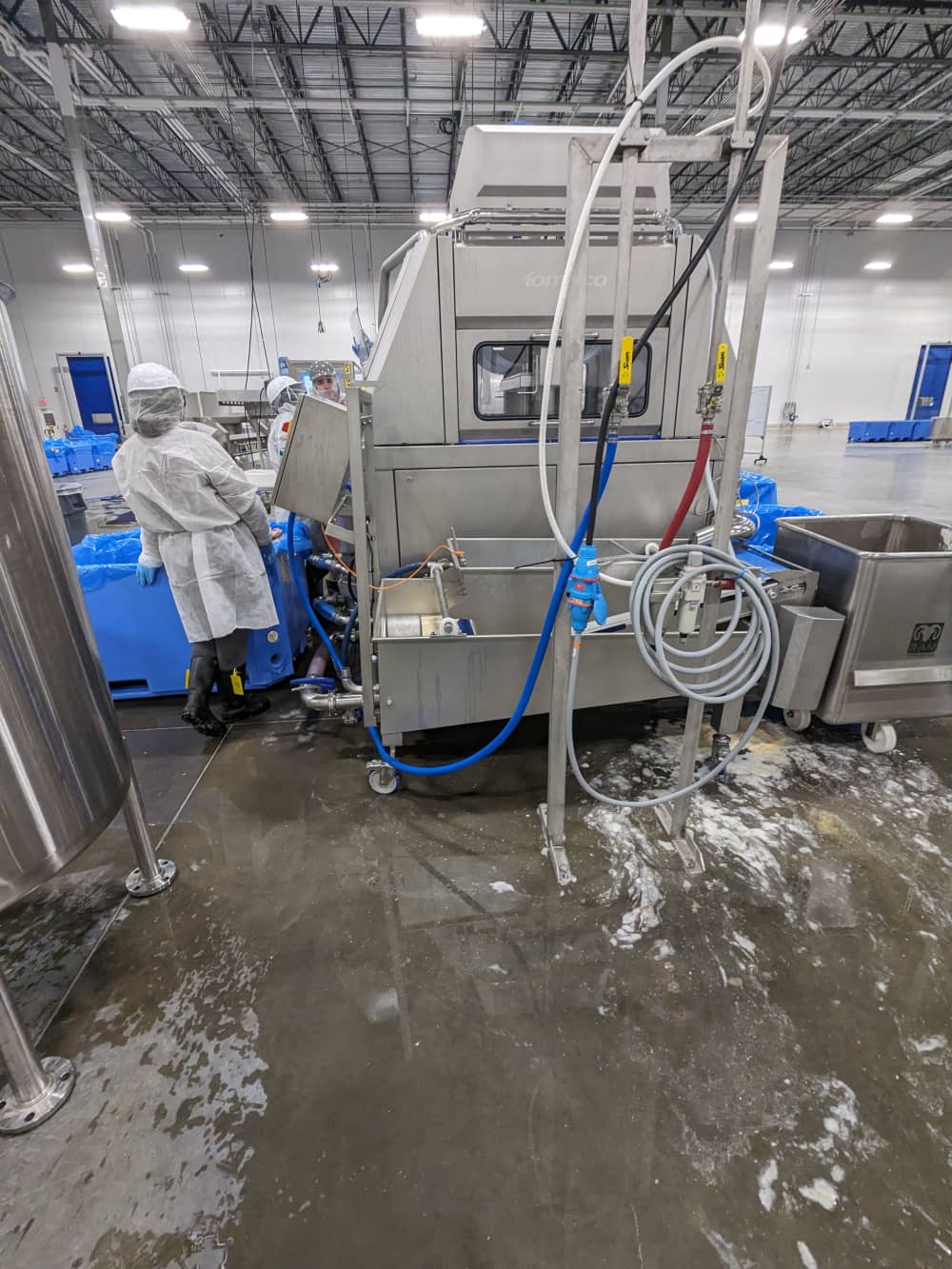

    Underfloor pipe insulation check, control terminations, SCADA controls dry run, temperature mapping, and Clean-In-Place validations completed.

  5. Week 10 🎉

    TCO & Go-Live

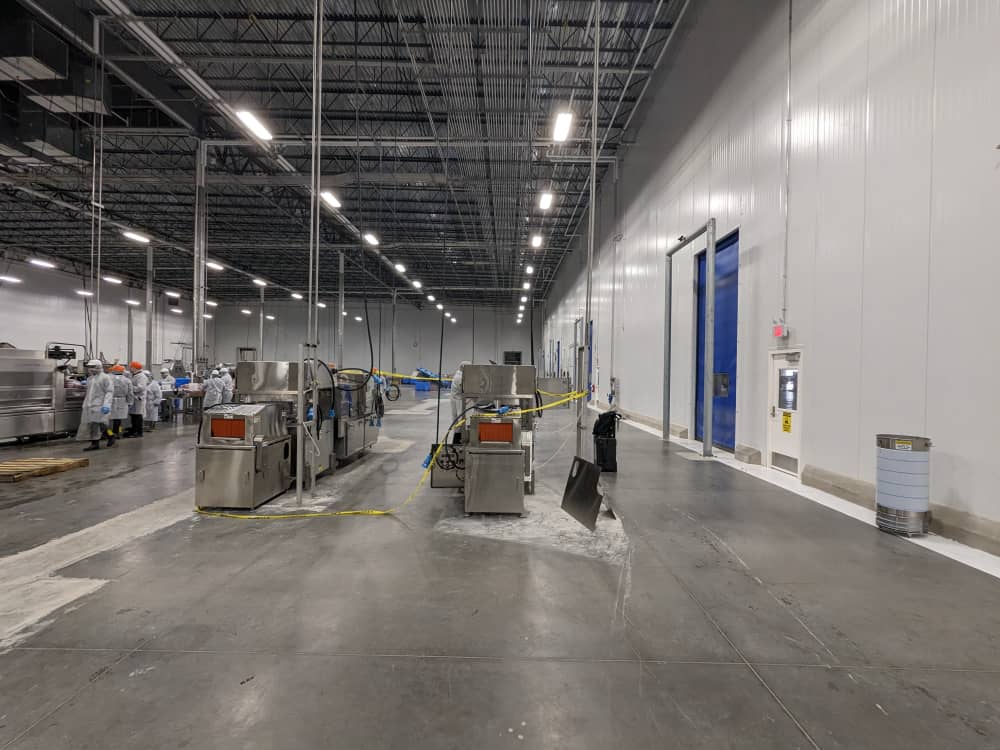

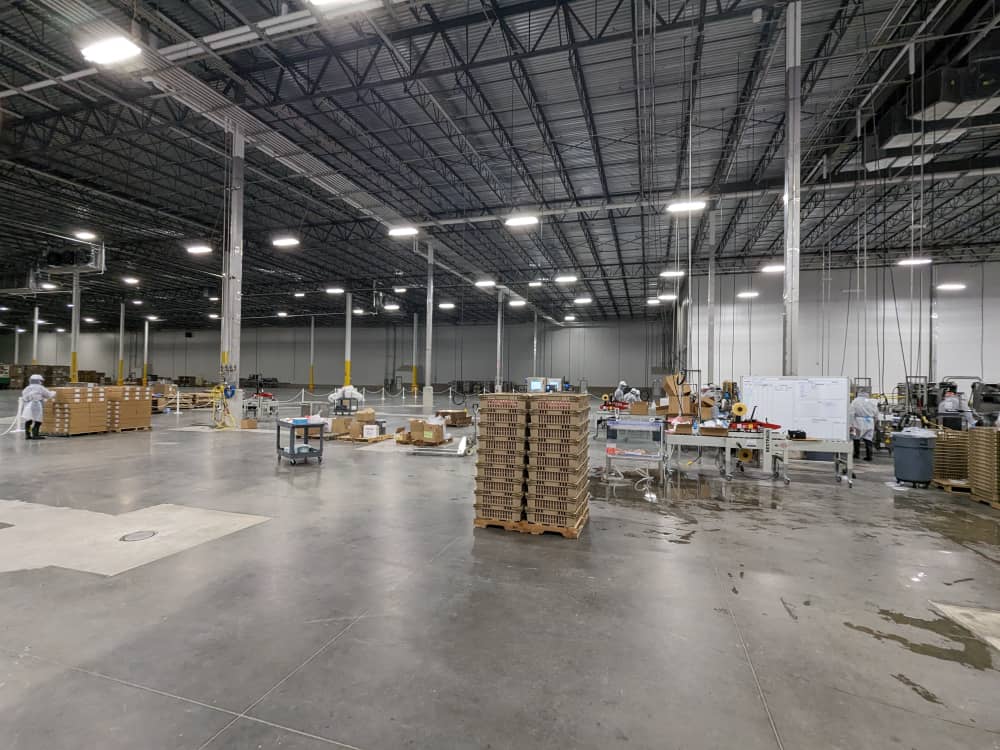

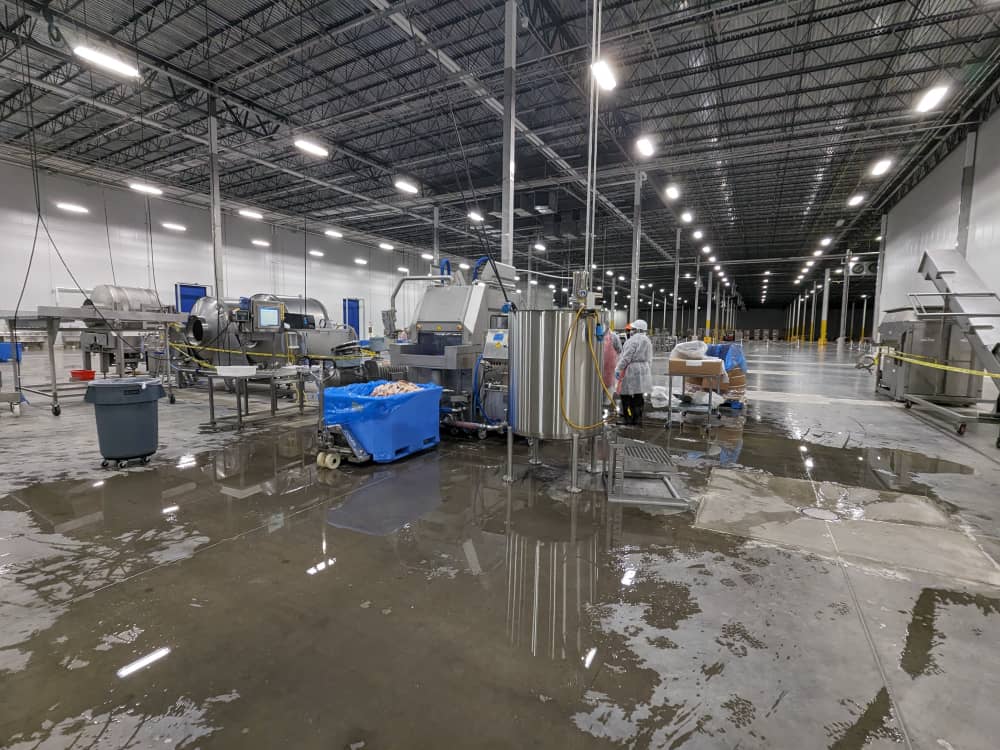

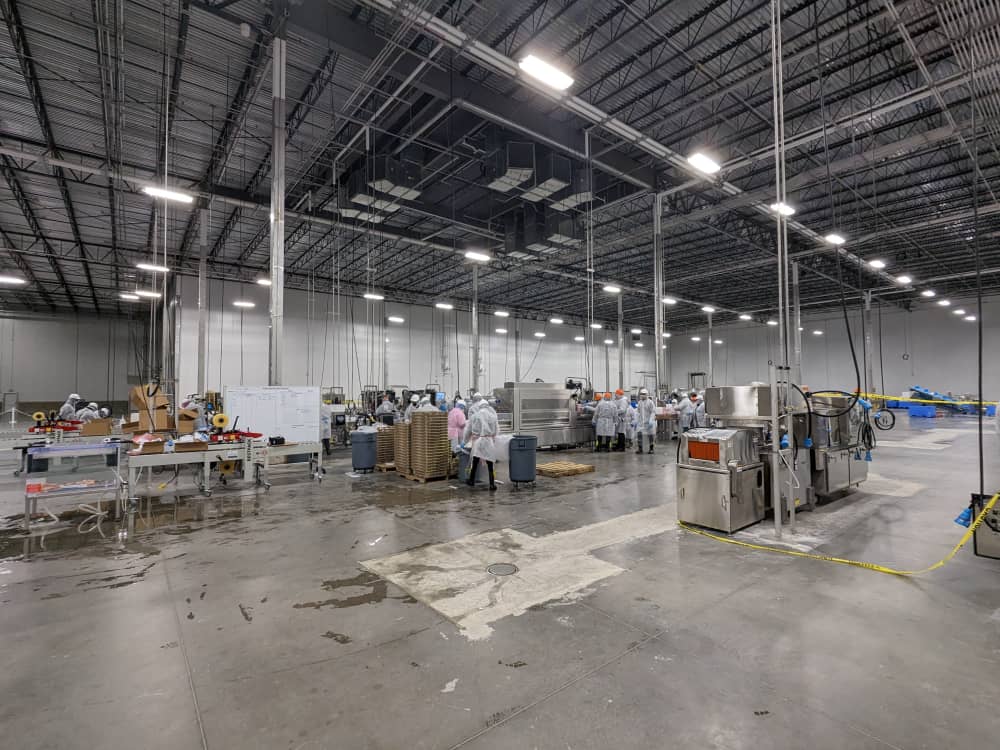

    Temporary Certificate of Occupancy granted April 8. First official production runs completed with zero material waste or customer delay.

Connect With Senior Engineering Specialists

Connect With our Design-Build Architects

Let’s map out how DPS can deliver your next greenfield setup, line expansion, or complex process plant relocation with similar timing precision and zero commercial lag.
