Case Study • Meat Processing

Confidential Client Ground Beef Line Execution

350,000 lbs/week line in just 6 months

Rapidly engineered, permitted, and installed to minimize downtime. Strategic development allowed lower rate production to proceed key weeks before full commissioning, creating early client return.

Fast-Track Turnkey Execution Timeline

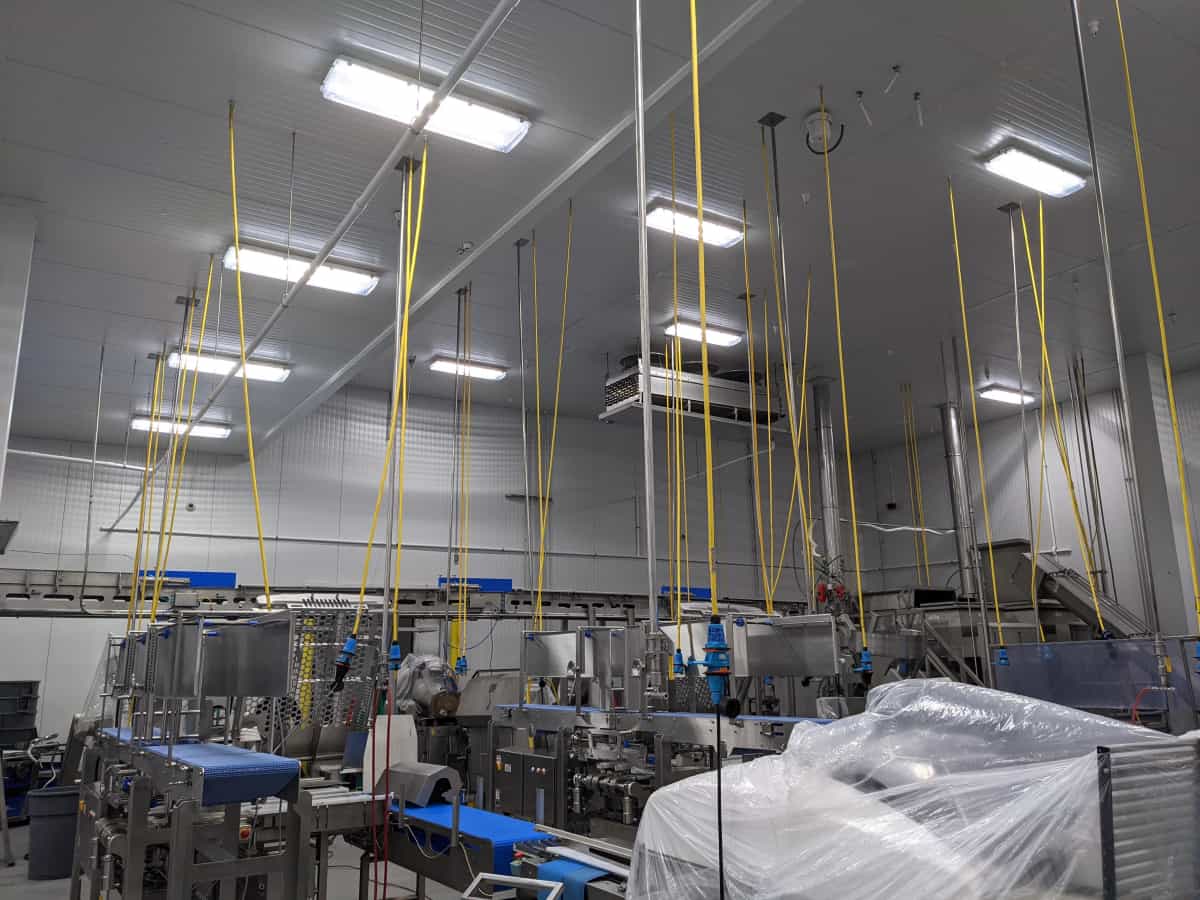

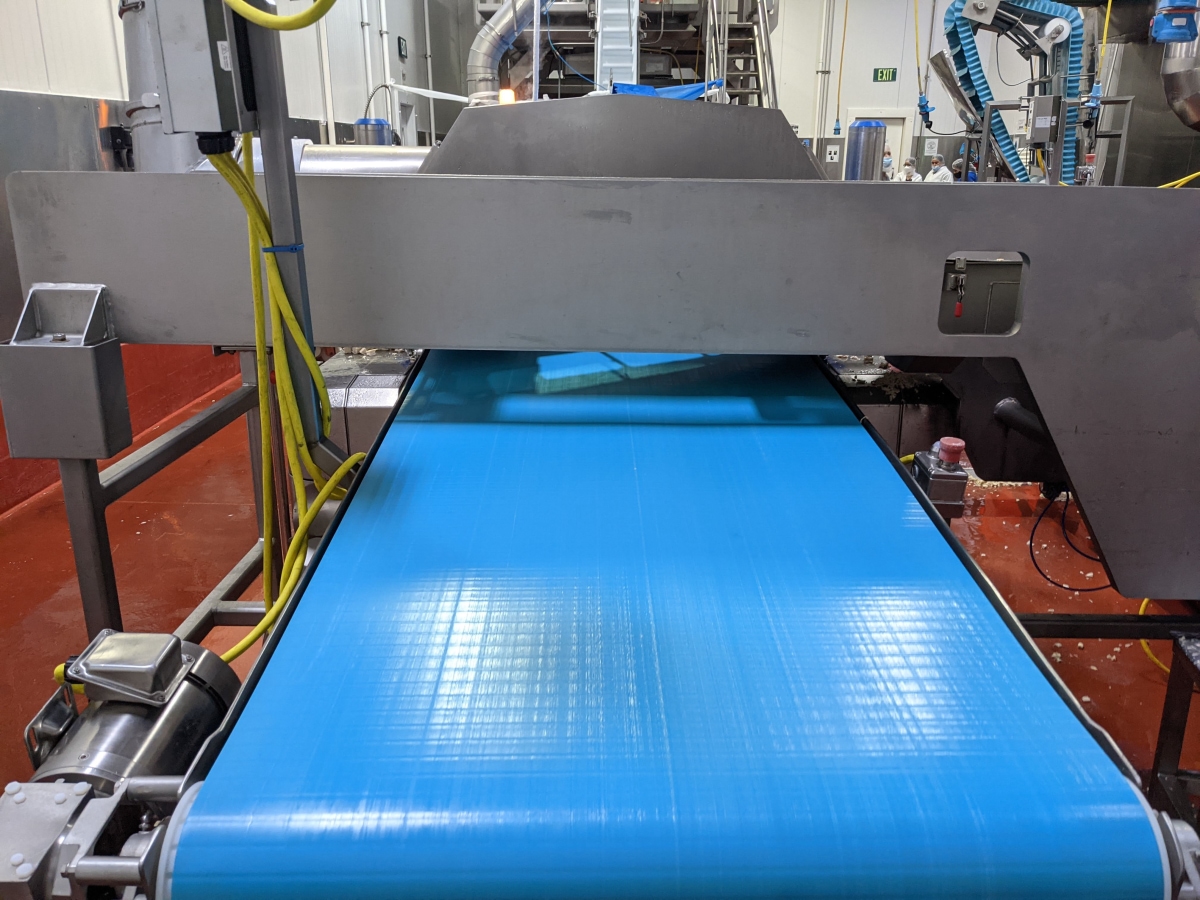

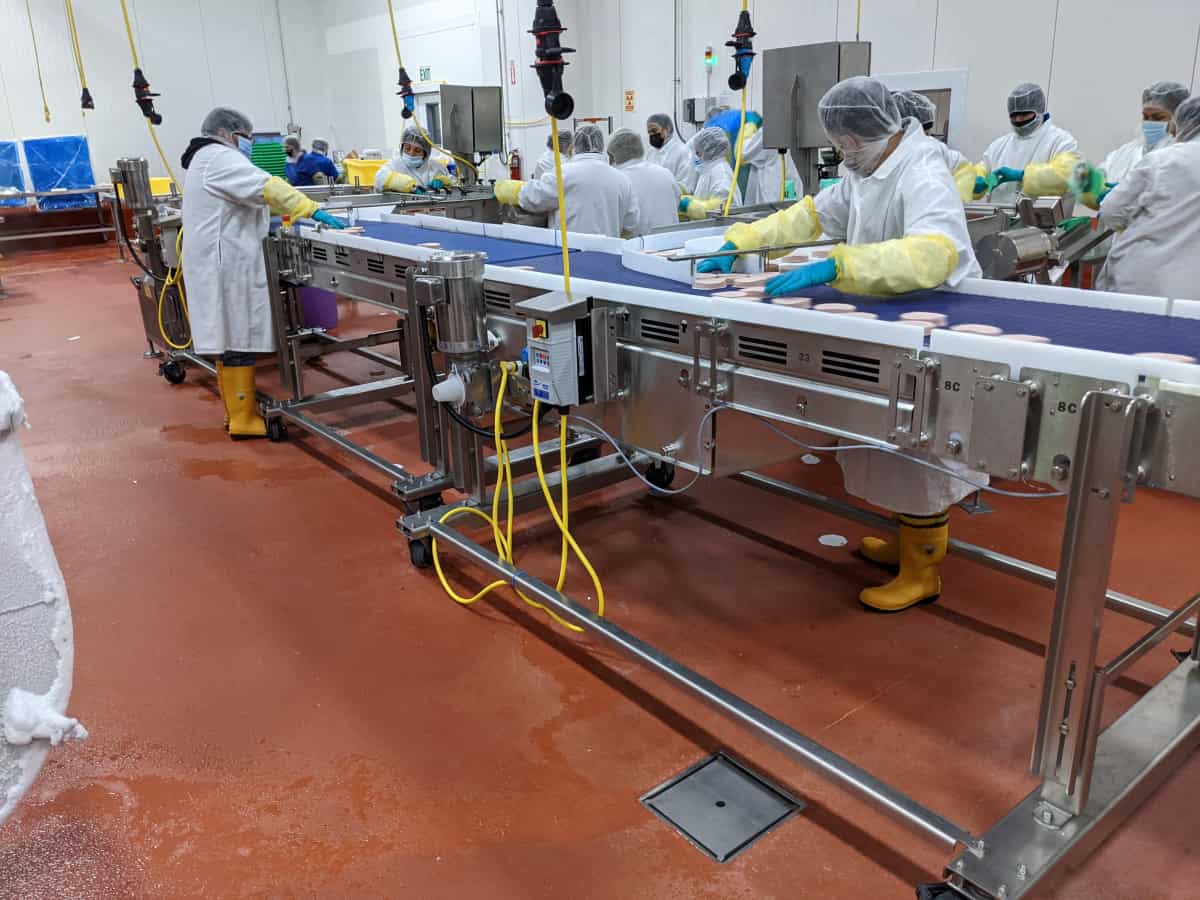

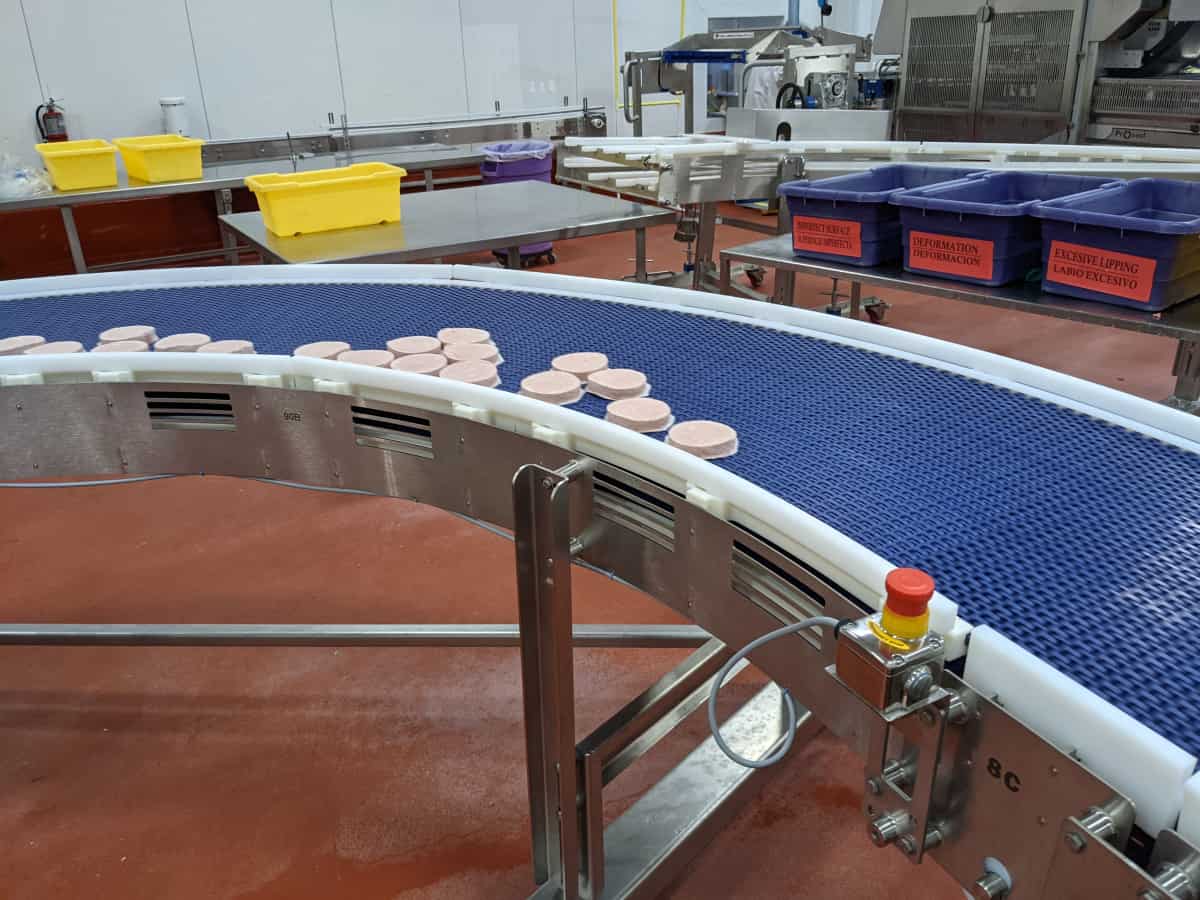

Active LineActive ground beef packaging line integration
Revenue atWk 11 Active

Complex Facility Setup

Live operational retrofits based in LA

12 Trade Contractors

Simultaneously synchronized by DPS

Minimized Interuption

Only 4 weeks cumulative downtime

Revenue Extraction

Activated key production early

Key Performance Successes

Critical Timelines • High Performance Results

350K lbs

Beef Volume Weekly

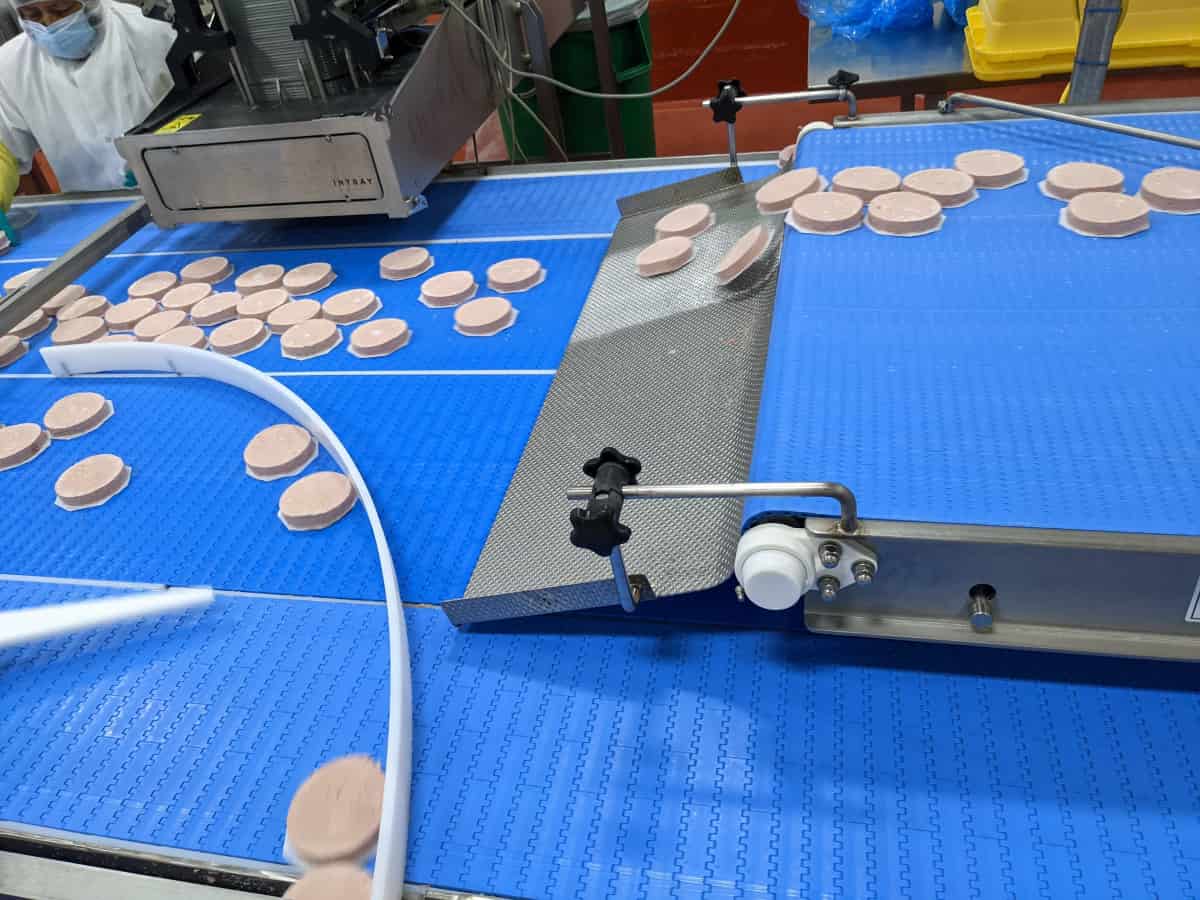

Substantial volume increase with clean room slicing, loading and sealing integration.

6 Mos

Turnkey Execution

All permitting, structural updates, mechanical placement, and utility alignment.

4 Wks

Downtime Contained

Ongoing commercial deliveries remained prioritized with minimal offline impact.

Wk 11 Go

Early Production

Lower-rate operations deployed weeks ahead of full validation checklist completion.

Case Context

The Challenge: Installing High-Volume Capacity in Concurrently Running Facility

The client required a major capacity expansion inside an existing, highly active Los Angeles manufacturing plant with a target of installing a massive 350,000 lbs/week high-capacity ground beef processing line.

With peak sales season looming, shutting down operational segments was out of the question; cumulative production timeline disruptions could not exceed four weeks. Fire protection codes, local permits, and physical mechanical moves had to occur concurrently while other lines maintained volume.

DPS METHODOLOGY

Design • Build • Manage – Dynamic Alignment

Stage One

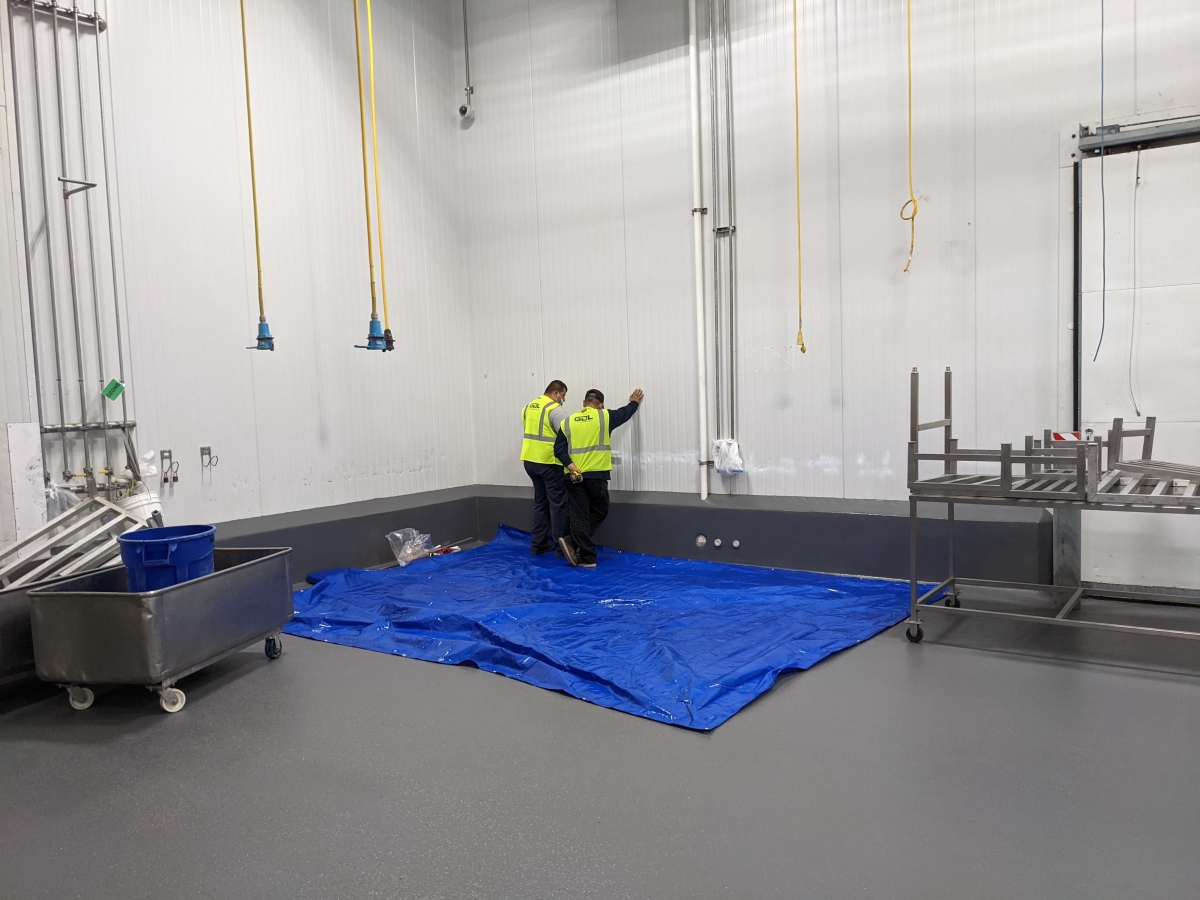

DESIGN

All disciplines engineered within 4 weeks. Key process assets ordered first to eliminate logistics delivery lag. Fully reconciled fire suppression system within existing layout parameters.

Stage Two

BUILD

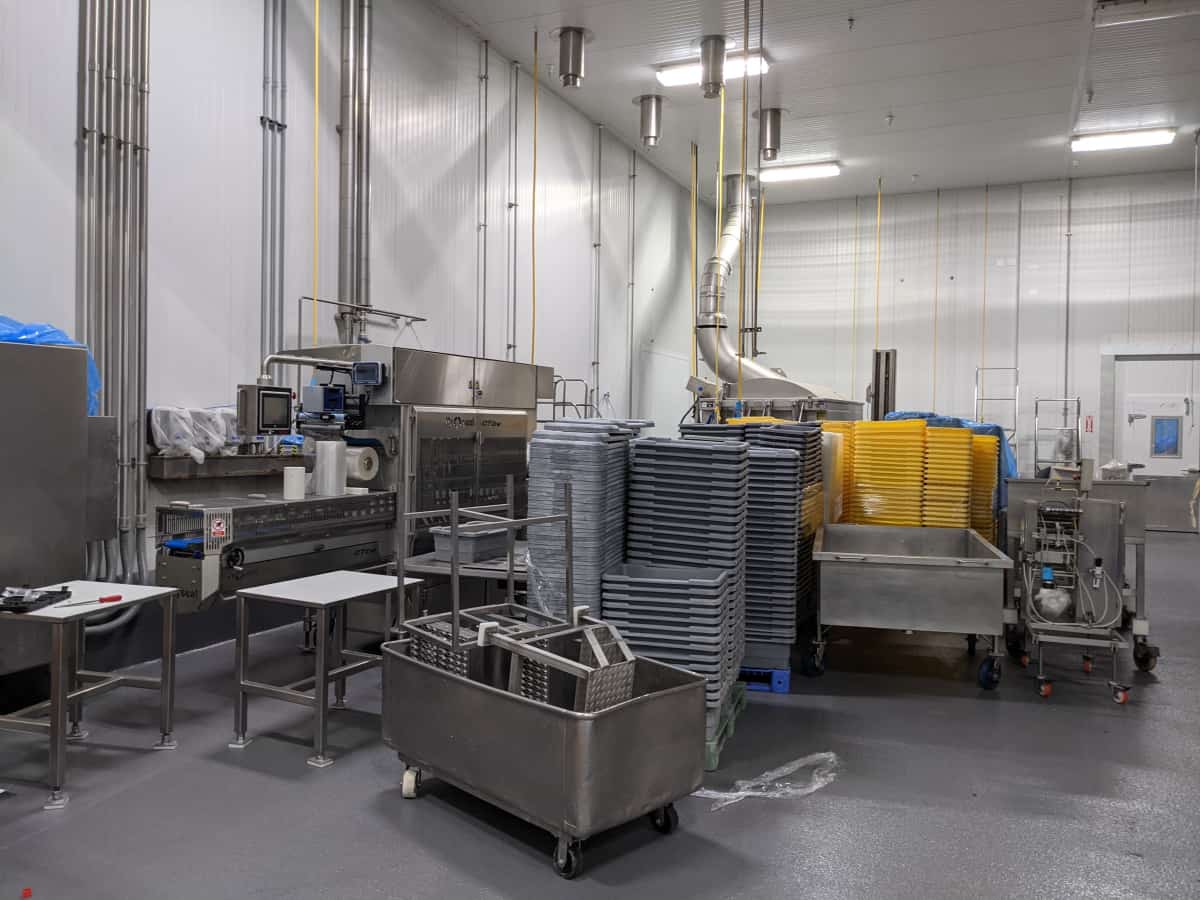

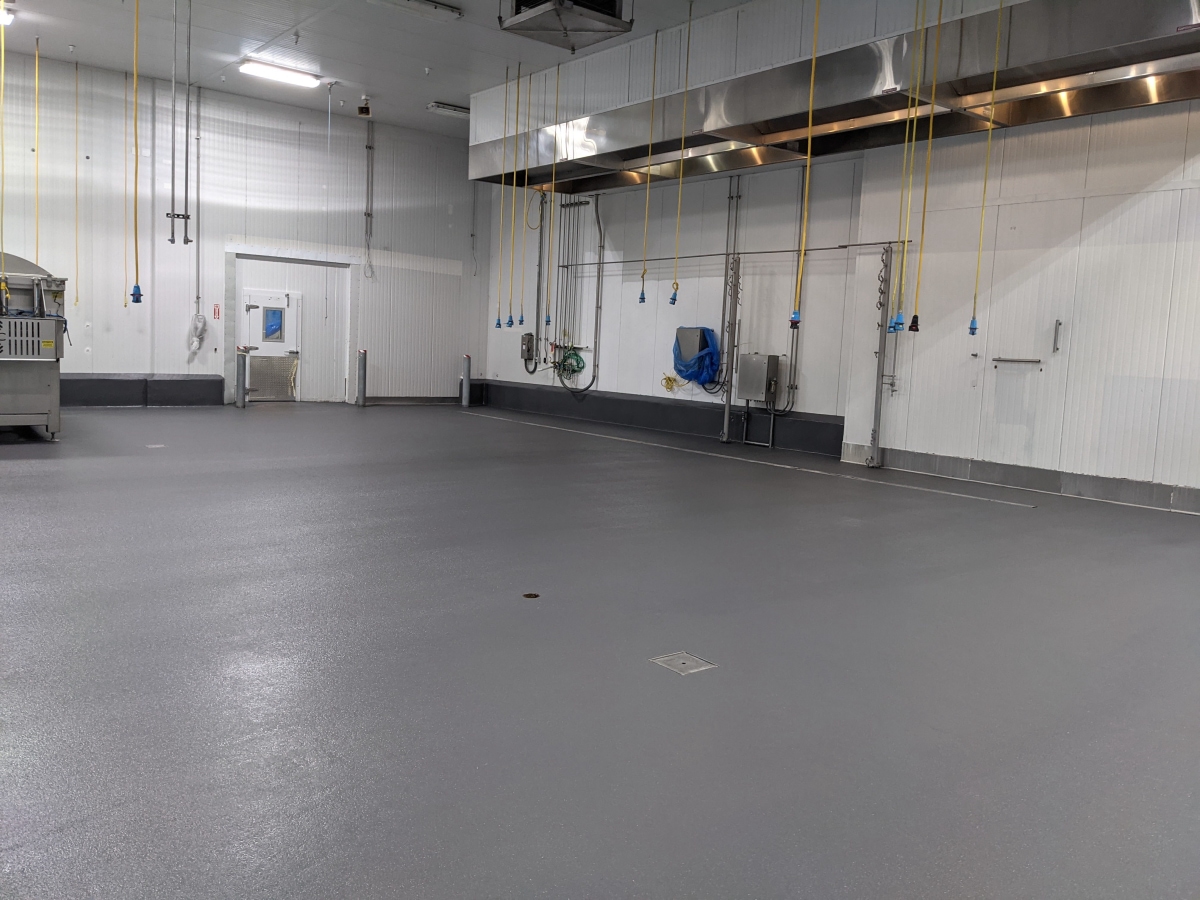

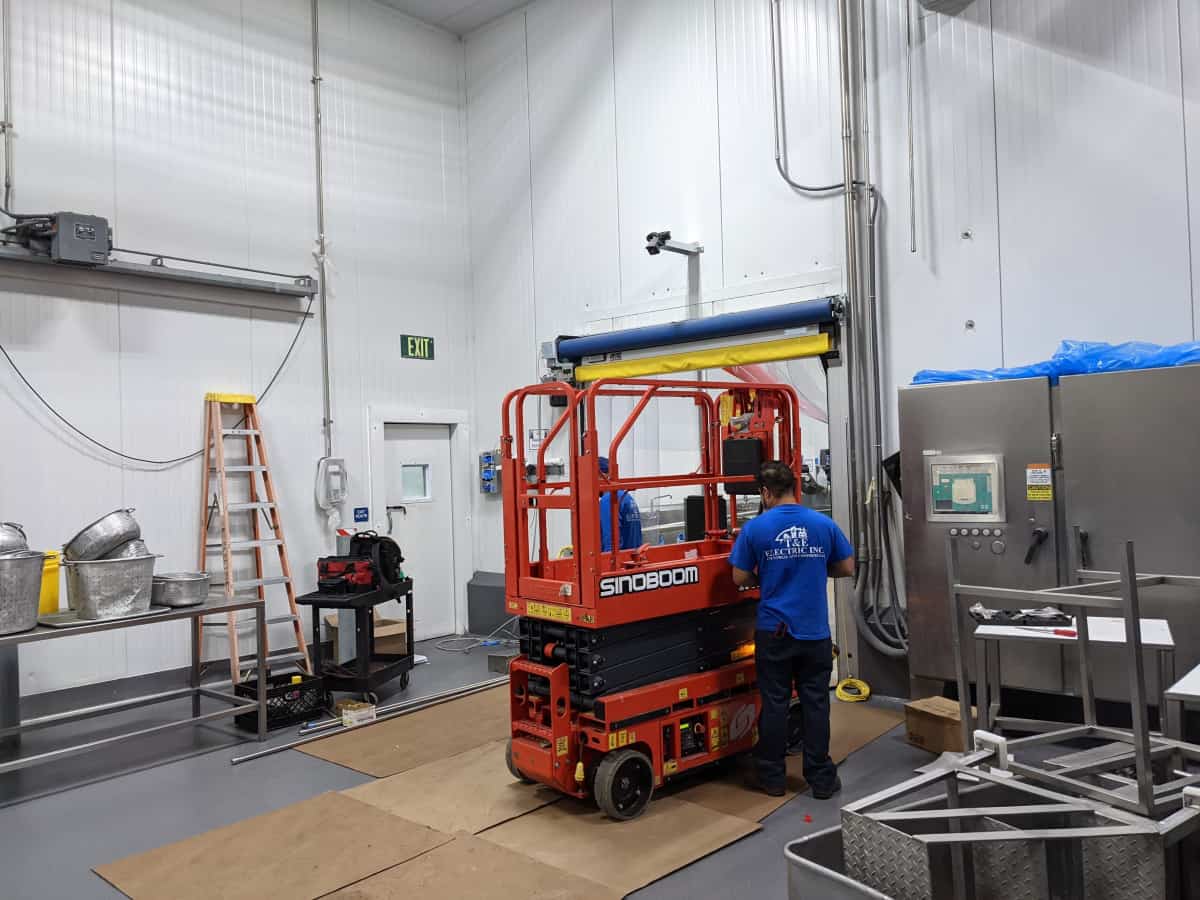

Turnkey field representation managing 12 specialty contractors. Handled processing room relocations, slab adjustments, utility piping hooks, and sanitation boundary walls cleanly.

Stage Three

MANAGE

Focused project management with weekly dashboarding logic. Designed and activated phased production by Week 11, giving the client early market capitalization months before baseline closeout.

EXECUTION TIMELINE

Phased Relocation & Capacity Delivery Timeline

Turnkey Delivery Completion

  1. Weeks 1–4

    Engineering & Permits

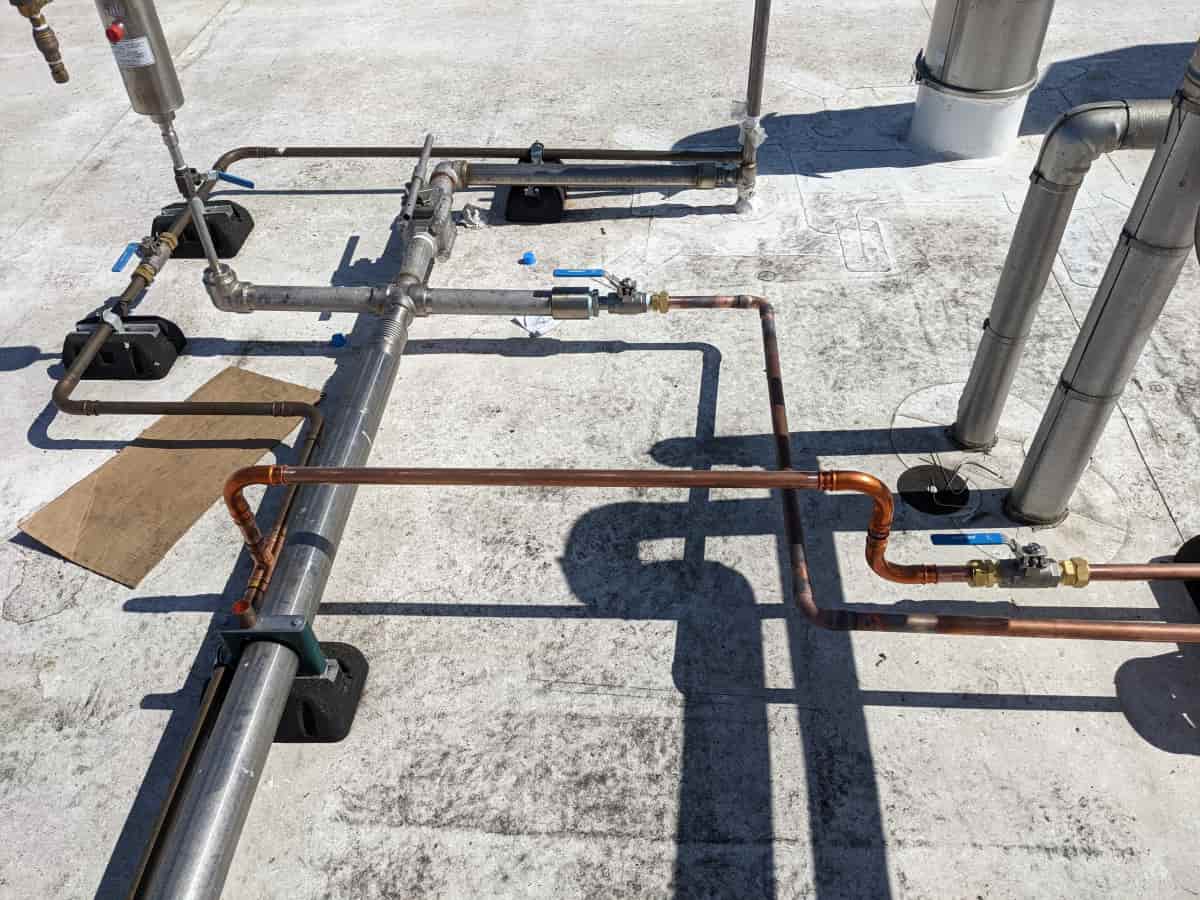

    Structural, MEP designs calculated. Immediate equipment acquisitions placed. Approvals fully released in Los Angeles county.

  2. Weeks 5–10

    Installation & Retrofit

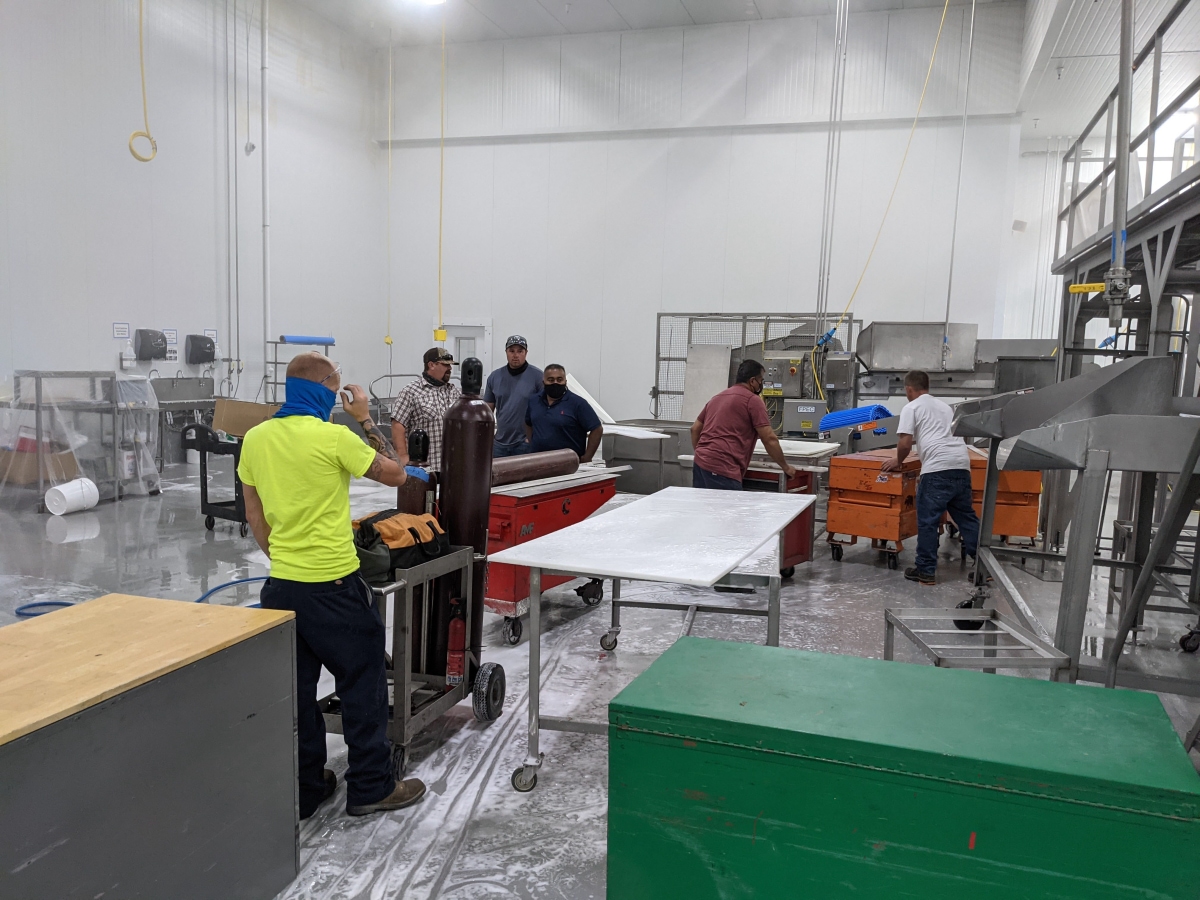

    Under-floor utility trenches cut, process pipes distributed. Line assets positioned and existing processing room relocated elegantly.

  3. Week 11 🎉

    Early Production

    Relocated slicing room delivered. Early lower-rate operations initialized to protect active product supply goals.

  4. Weeks 12–20

    Full Integration

    Fire prevention safety nets run, complex control calibrations finished and SCADA systems certified with only 4 weeks operational gap.

  5. Month 6

    Full Scale Achieved

    Ground beef line running at maximum 350,000 lbs/week layout with zero delay or supply defaults reporting.

Senior Lead Design Team Review
